Case study / Pell Lake basement

An 840 sq ft basement, from storage to living space.

Bare concrete, exposed joists and a closed stair. The owners needed a home office, a family room and a bathroom for guests.

House
1998 two-story
Area
840 sq ft finished
Contract
$78,600 fixed
Change orders
None
Schedule
31 of 32 days
Project manager
Dana Okafor
Finished basement with an open stair, a built-in desk and an LVP floor

Sheet P-112 / Sequence

Day by day

Drag along the strip to step through the job. Days are working days, Monday to Friday.

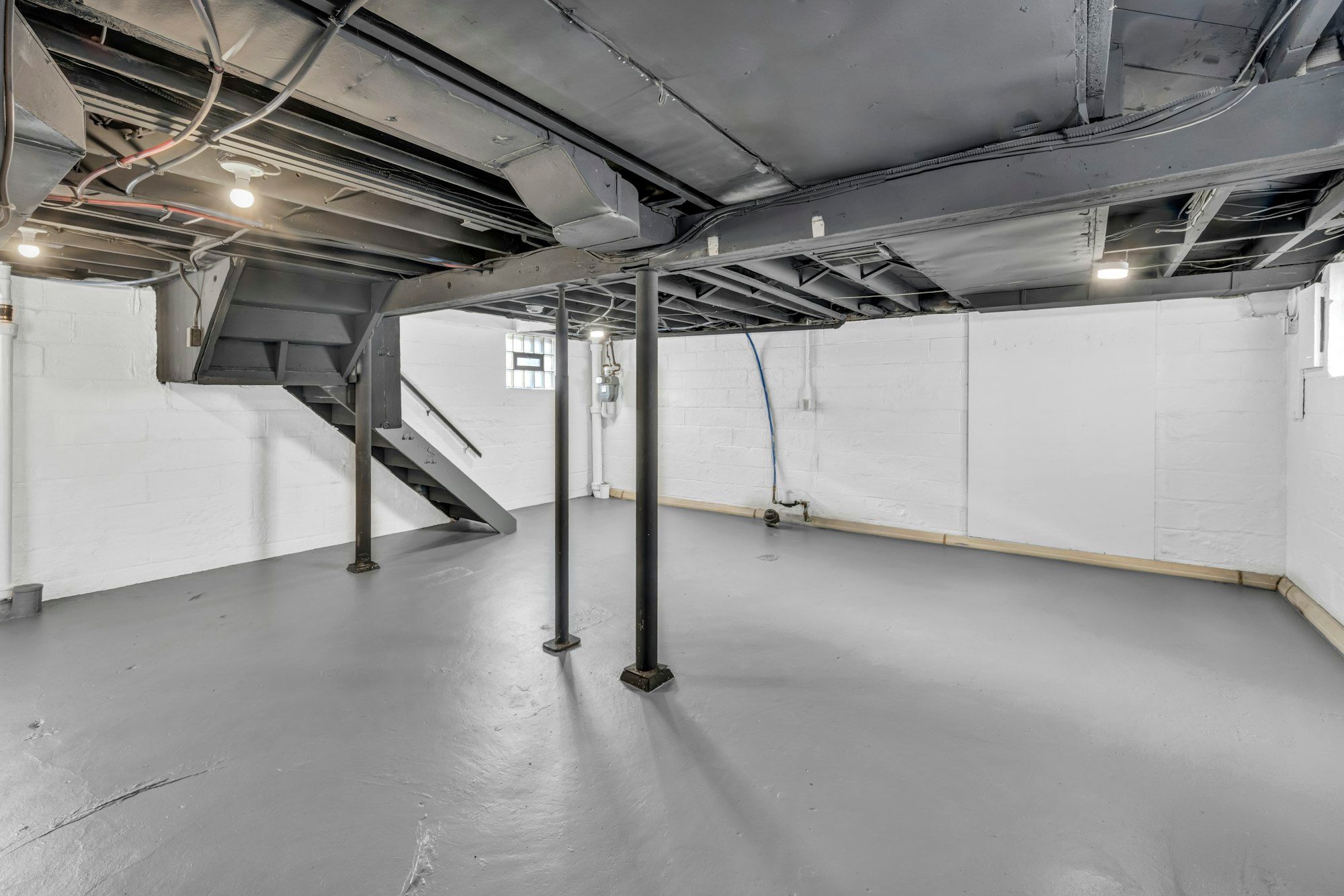

Unfinished basement with exposed joists, steel posts and an open stair
Carpenter marking a cut line on a board with a pencil

Framed walls and an insulated ceiling in a basement under construction

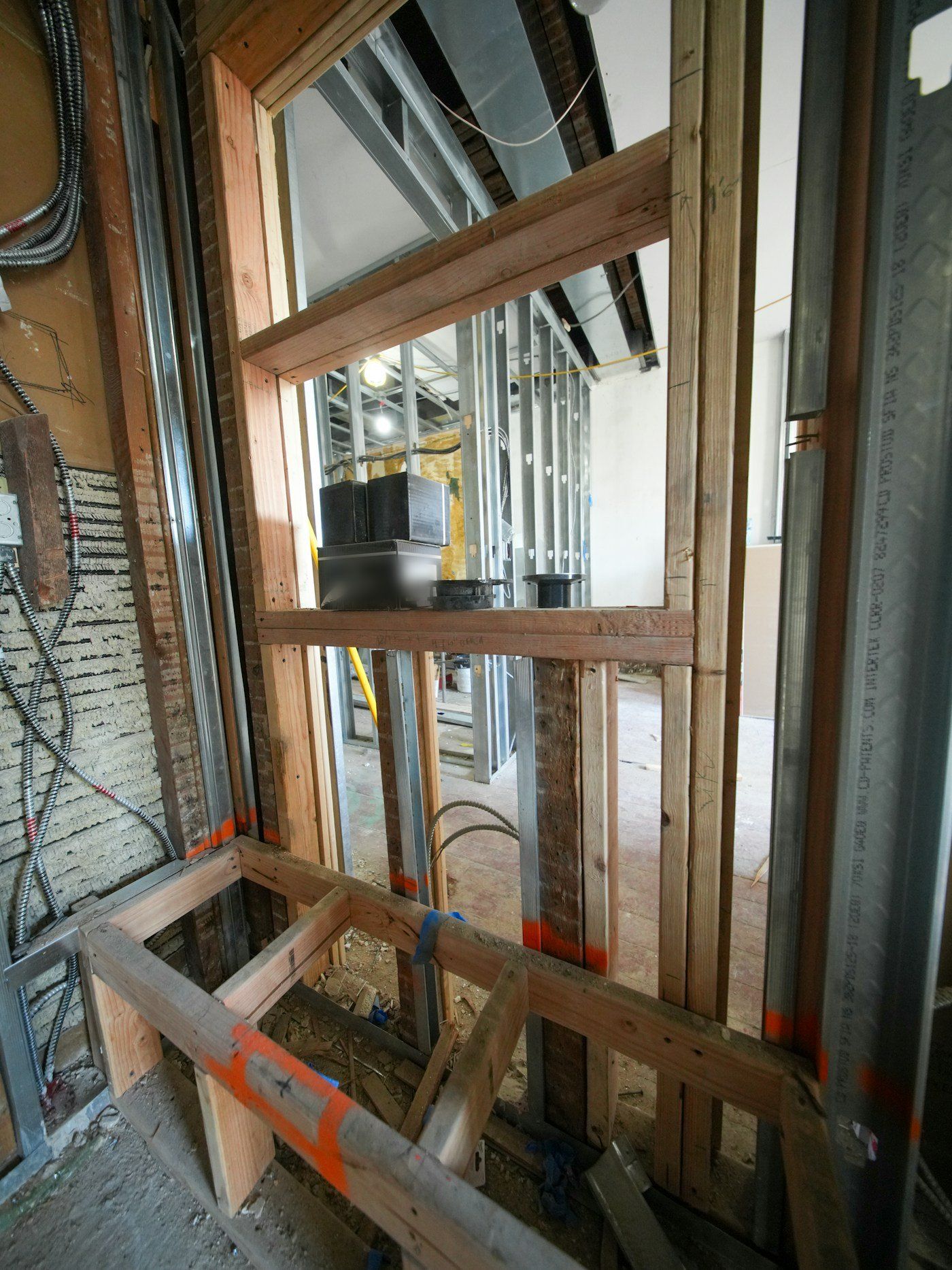

Open framing with electrical boxes and cable

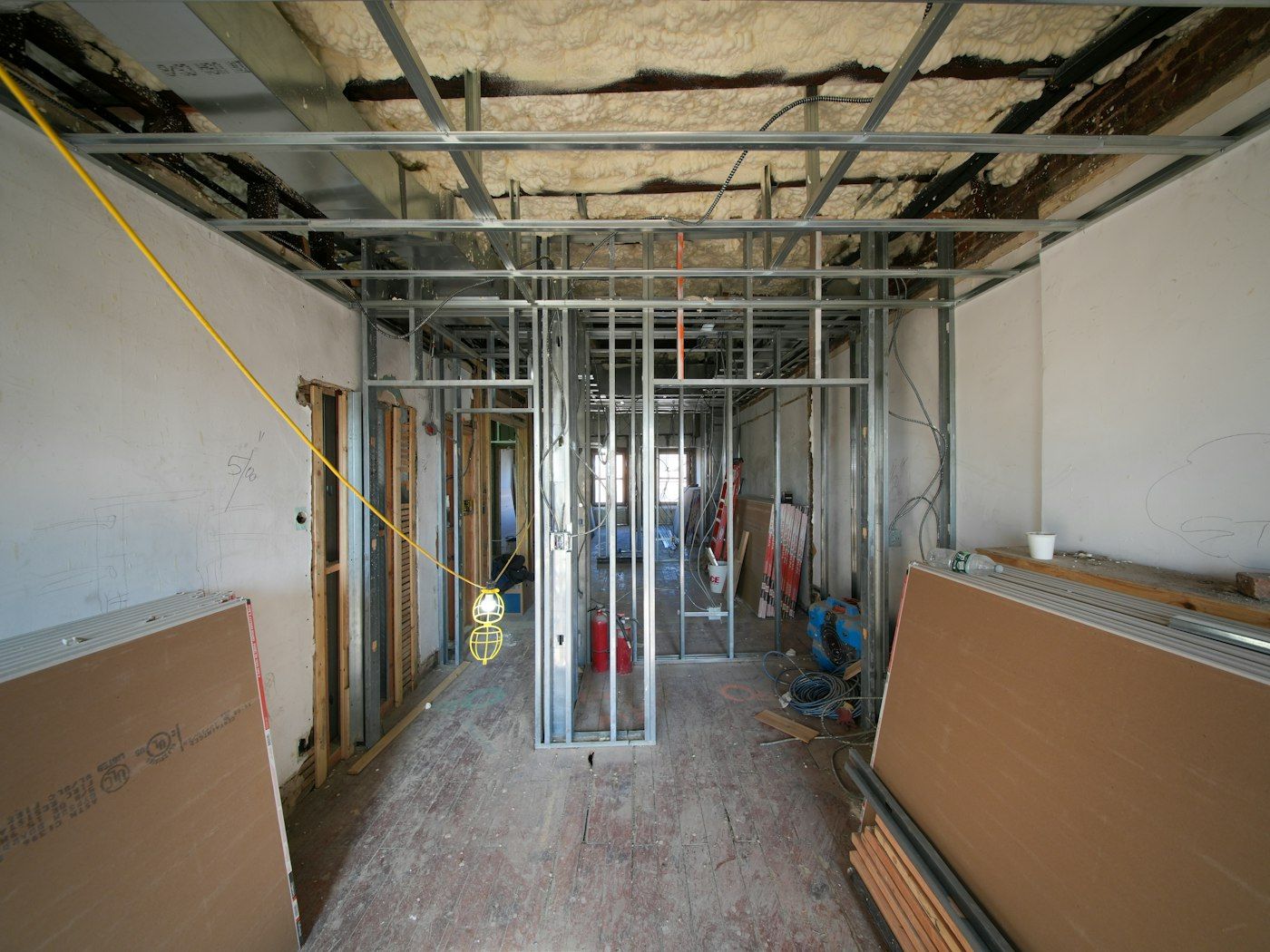

Drywall sheets stacked against new framing
Basement room freshly painted with the closet door hung

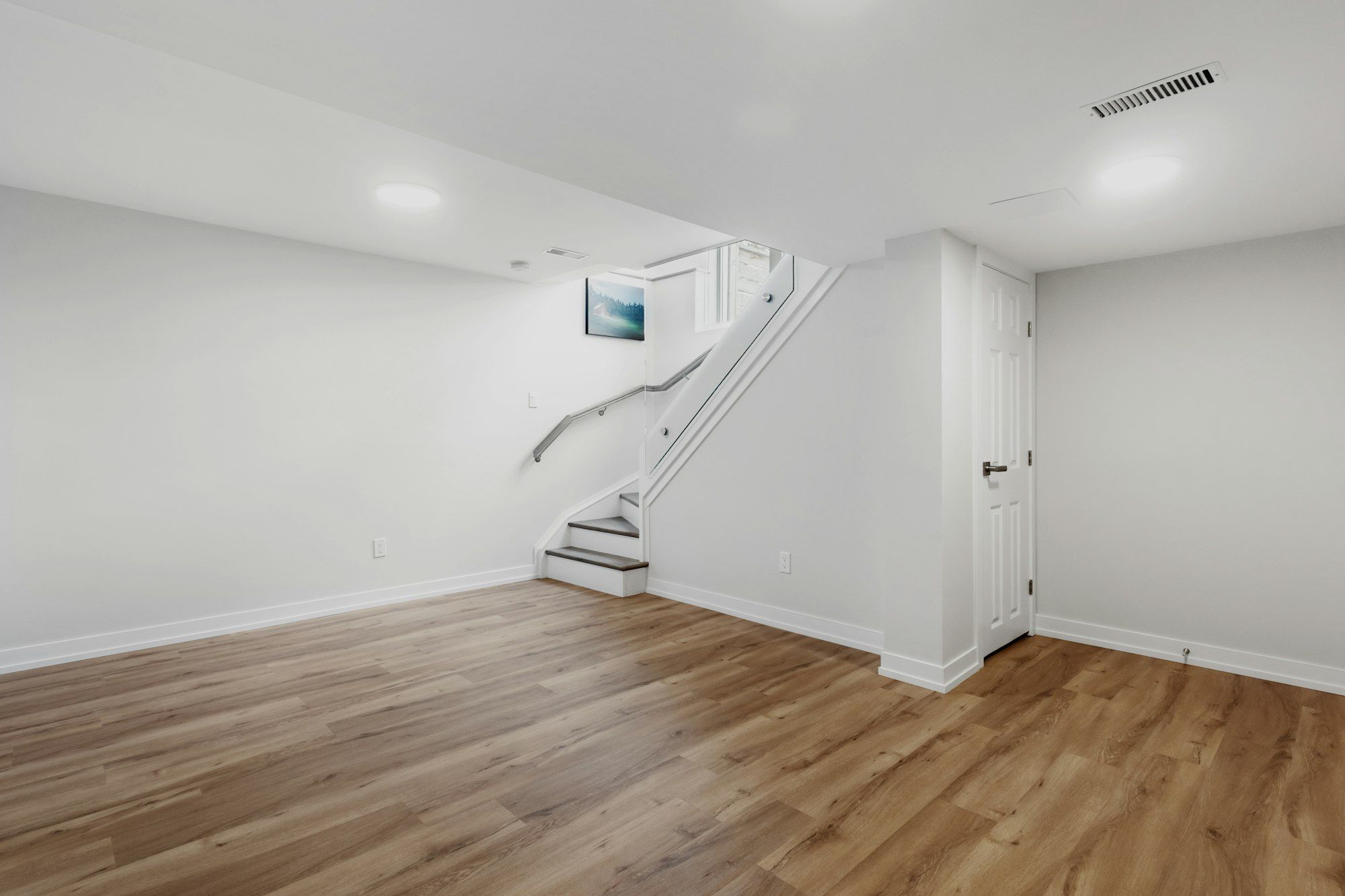

Finished basement room with new LVP flooring and white walls
Finished basement with an open stair and a built-in desk

Day 1

Moisture test and layout

48-hour moisture test passed. Walls and soffits snapped on the floor in chalk to match the drawings.

Day 3

Egress window and plates

Foundation saw-cut, well set and window installed in one day. Inside, bottom plates cut and marked to the chalk lines.

Day 6

Insulation and framing

2 in foil-faced foam on all exterior walls, spray foam at the rim joist, 2x4 walls set 1/2 in off the foam.

Day 10

Rough-ins

Slab cut for the bathroom drain, supply lines run, 22 recessed lights and a dedicated office circuit. All rough inspections passed on day 12.

Day 14

Drywall

Moisture-resistant board in the bathroom, standard elsewhere. Taped and finished to level 4.

Day 19

Paint, doors and tile

Primer and two finish coats. Doors hung and base trim set. Shower walls waterproofed with a sheet membrane, then tiled.

Day 24

Flooring

Waterproof LVP with an attached pad over the whole slab. Transitions flush at the bathroom and stair.

Day 31

Walkthrough

Final inspection passed on day 29. Built-in desk and stair guard finished. 7 punch items closed on the last day.

Inspections: rough plumbing, electrical and framing day 12, insulation day 13, final day 29.

Sheet P-113 / Comparison

Before and after

Drag the line, or tab to it and use the arrow keys.

Finished basement with an open stair and a built-in deskAfter / day 31
Unfinished basement with exposed joists and steel postsBefore / day 1
Drag to compare the basement before and after
Same stair location. The steel posts are boxed and the ductwork sits in one straight soffit.

Sheet P-114 / Walkthrough

Walkthrough with Dana

Dana is filming the insulation detail on our next basement, so this one will show the layers before the drywall hides them.

Basement under construction with framed walls and an insulated ceiling

Video coming soon3:48

Insulating a Minnesota basement the right way

Captions included.

In this video

  1. 0:00Moisture test results
  2. 0:55Foam board and rim joist
  3. 2:10Bathroom drain under the slab
  4. 3:05The finished space

What Ben and Shauna wrote afterwards

Dana sent a schedule every Friday, what got done and what was next. Inspections were booked before we thought to ask. Egress window went in day 3 and the bathroom passed rough-in first try. The basement is an actual room now instead of where boxes go to die.

Ben and Shauna R.Pell LakeBasement finish, 840 sq ft with bath
